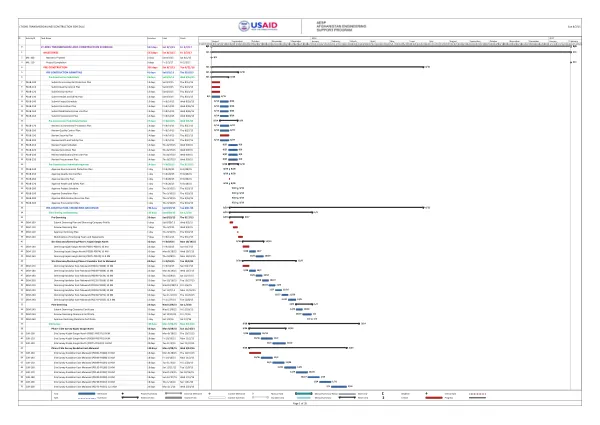

The transmission lines construction schedule for the LT-0091 project began on August 1, 2015, and was completed on February 3, 2017.
2015 · 35 pages

Abstract
The project duration was 553 days. The project was divided into several phases, including pre-construction, engineering and design, and construction. Pre-construction activities started on August 1, 2015, and lasted for 326 days. This phase included the submission of pre-construction submittals, which began on August 1, 2015, and were completed on September 10, 2015. The pre-construction submittals review phase started on August 14, 2015, and lasted for 27 days. The engineering and design phase began on August 29, 2015, and lasted for 298 days. This phase included site clearing and demining, which started on August 29, 2015, and was completed on January 2, 2016. The demining phase was divided into several tasks, including the submission of demining plans and the mobilization of demining teams. Site survey activities started on September 28, 2015, and lasted for 169 days. This phase included the submission of site survey reports, which began on February 25, 2016, and were completed on March 14, 2016. The site survey report review phase started on February 29, 2016, and lasted for 14 days. Soil investigation and geo-technical activities began on October 16, 2015, and lasted for 167 days. This phase included the submission of soil investigation reports, which started on December 5, 2015, and were completed on March 30, 2016. The soil investigation report review phase began on December 25, 2015, and lasted for 14 days. Design and engineering activities started on March 31, 2016, and lasted for 83 days. This phase included the submission of structure design and specifications, which began on March 31, 2016, and were completed on May 14, 2016. The structure design review phase started on May 15, 2016, and lasted for 14 days. The project timeline was divided into several milestones, including the notice to proceed, project completion, and the submission of various reports and plans. The project was completed on February 3, 2017, with a total duration of 553 days.
Connected topics
Classification

USAID DEC
