USAID DEC

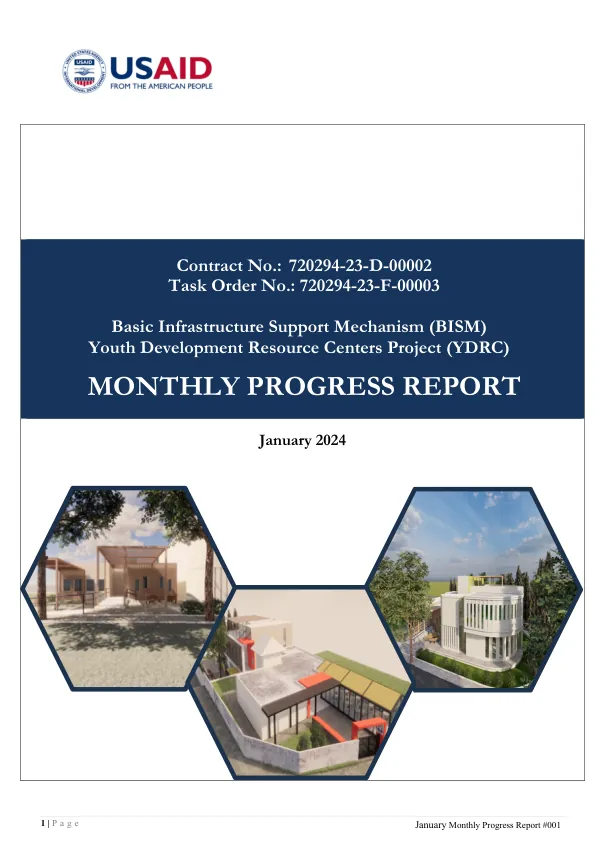

The Youth Development Resource Centers Project (YDRC) is a Task Order under the Basic Infrastructure Support Mechanism (BISM) contract, with the objective of expanding and improving existing YDRC facilities in Tulkarem and Tubas to provide additional space for youth programs and a better environment for recreation and learning.
2024 · 48 pages

Abstract
The project aims to enhance conditions that facilitate the involvement of young women by creating a safer and more supportive environment for them to participate in development activities. The project involves the construction of a new two-floor building for the Tulkarem YDRC with a total area of approximately 740 m2, including landscaping and improvements of the existing facility. Similarly, a new two-floor building will be constructed for the Tubas YDRC with a total area of approximately 800 m2. Works include demolishing and reconstructing the existing Tubas YDRC cantina space, repairs and repainting at the existing facility, construction of a new facility entrance, and landscaping. The project is located in Tubas and Tulkarem cities, with the owner being Tubas YDRC and Tulkarem YDRC. The donor and client is USAID, with the Contracting Officer being Rami Abu Ktaish and the Construction Management Contractor being AECOM. The Notice of Award was issued on September 29, 2023, and the Notice to Proceed was given on December 28, 2023. The project duration is 360 calendar days, with a completion date of December 21, 2024. The contract value is $5,869,276.60, with a BOQ line-item amount of $5,351,692.00 and a day works amount of $250,000.00. The Task Order's Key Personnel have been approved, with the Task Order Manager being Talal Atallah, the Quality Control Manager being Ghaleb Najajreh, and the Safety & Environmental Compliance Officer being Mamoun Kharraz and Majd Mashaleh. The Project Engineers are Raed Najjar and Osameh Azzeh. The project has a geographical focus on Tubas and Tulkarem cities, with a specific emphasis on enhancing the involvement of young women in development activities. The project has made progress in the first month, with the Post Award Meeting held on January 31, 2024. However, the project has not yet started construction, with the start date still to be determined. The project's Critical Path Method (CPM) baseline schedule is still under preparation, and therefore the planned and actual percentage of completion cannot be determined. The project has a float of NA, indicating that the project schedule is still being developed.
